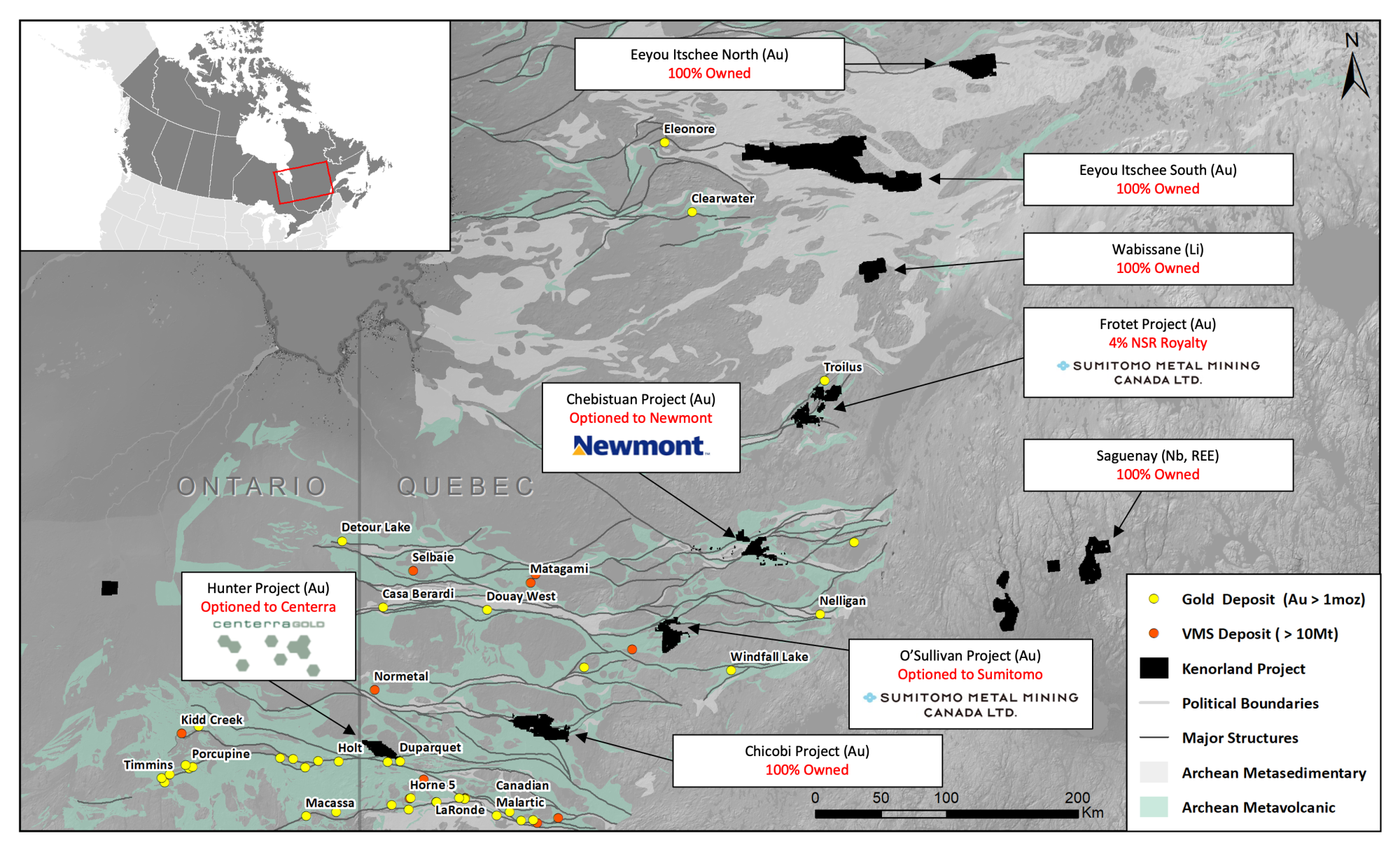

In 2019, the Company acquired the O’Sullivan Project through map staking.
In September 2020, a LIDAR survey was completed and used to plan a property-wide surface geochemical survey. In the summer of 2020, 1,322 B-horizon till samples were collected on a 1000m by 200m grid as a first pass reconnaissance-style program with the objective of identifying geochemical anomalism within the glacial till cover.
During October of 2021, a follow up till sampling program was completed, infilling six target areas which were identified during the initial 2020 geochemical survey. The infill soil sampling was completed on a 50m by 250m grid with a total 487 soil samples collected.
Detailed electromagnetic (EM), IP and drone magnetic geophysical surveys were carried out in the spring of 2023, covering the coherent gold-in-till anomalism on the north shore of Lac Pusticamica. A lake sediment geochemical survey was completed in the summer of 2023 to assist in future drill targeting.
In the winter of 2024, Kenorland completed a maiden drill program of 5 drillholes for 3,801 meters of drilling at the Pusticamica North target area. Hole 24OSDD001 identified visible gold at 475m depth and returned 56.80 g/t Au and 23.60 g/t Ag over 0.30m core length associated with a brecciated quartz-calcite-sulphide vein. The remaining 4 holes identified a large syenite dike swarm characterised by variable hematite-silica alteration within volcanic rocks associated with silica-sericite-calcite-albite alteration but did not return any significant mineralisation. The O’Sullivan Project is held under an earn-in agreement with Sumitomo Metal Mining Canada Ltd.
On November 11, 2025, Kenorland announced commencement of a 2025 fall drill program at the O’Sullivan Project in the Abitibi greenstone belt of Quebec. A total of 3,375 metres of drilling was completed across seven diamond drill holes testing a structurally complex corridor along the Casa Berardi Deformation Zone, which was defined through five years of systematic exploration including soil geochemistry, geological mapping and geophysics. The project is under option to Sumitomo, and assay results are expected in Q1 2026.
